Den

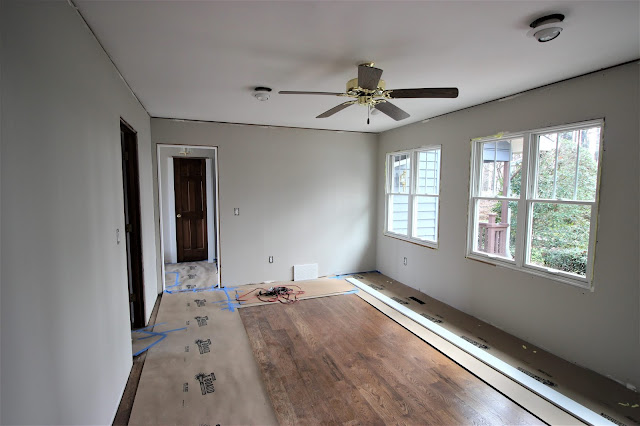

Original Condition on Closing Day
Plans - Everything will be replaced - floor, windows, fan, lights, and walls. The cedar siding won the walls will be removed for reuse on the exterior as the french door will be replaced by a window. Other doors will also be replaced and will need the siding. The den walls will be drywall. Moulding will be replaced and painted white while leaving the doors as natural wood. Brown electrical units will be replaced with white.
Week 26 - Monday, April 20
Caulked moulding.
Week 25 - Monday, April 13
No significant changes as work was focused in other areas.
Week 24 - Monday, April 6
No significant changes as work was focused in other areas.
Week 23 - Monday, March 30
No significant changes as work was focused in other areas.
Week 22 - Monday, March 23
Installed mouldings.
Week 21 - Monday, March 14
Cut and painted moulding.
Week 20 - Monday, March 9
No significant changes as work was focused in other areas.
Week 19 - Monday, March 2
No significant changes as work was focused in other areas.
No significant changes as work was focused in other areas.
Plans - Everything will be replaced - floor, windows, fan, lights, and walls. The cedar siding won the walls will be removed for reuse on the exterior as the french door will be replaced by a window. Other doors will also be replaced and will need the siding. The den walls will be drywall. Moulding will be replaced and painted white while leaving the doors as natural wood. Brown electrical units will be replaced with white.
Week 26 - Monday, April 20
Caulked moulding.
Week 25 - Monday, April 13
No significant changes as work was focused in other areas.
Week 24 - Monday, April 6
No significant changes as work was focused in other areas.
Week 23 - Monday, March 30
No significant changes as work was focused in other areas.
Week 22 - Monday, March 23
Installed mouldings.
Week 21 - Monday, March 14
Cut and painted moulding.
Week 20 - Monday, March 9
No significant changes as work was focused in other areas.
Week 19 - Monday, March 2
No significant changes as work was focused in other areas.
Week 18 - Monday, February 24
Floor installation was completed. Installed ceiling lights. Finished electrical work.
Week 17 - Monday, February 17
Traced electrical circuit breakers and installed switch/outlet covers.
Week 16 - Monday, February 10
Installed HVAC vent.
Week 15 - Monday, February 3
Painted walls. Installed door frame.
Floor installation was completed. Installed ceiling lights. Finished electrical work.
Traced electrical circuit breakers and installed switch/outlet covers.
Week 16 - Monday, February 10
Installed HVAC vent.
Week 15 - Monday, February 3
Painted walls. Installed door frame.
Week 14 - Monday, January 27
Floors were stained and polyurethane applied. Started to cut moulding. Walls were primed.
Week 13 - Monday, January 20
Wood floor installed. Drywall installation completed.
Week 12 - Monday, January 13
Painted ceiling. Drywall installation started. Electrical boxes moved and switches, receptacles replaced with white units.
Week 11 - Monday, January 6
Windows and insulation were installed. Plywood subfloor was installed.
Week 10 - Monday, December 30
Christmas - no work.
Week 9 - Friday, December 20
No significant changes as work was focused in other areas.
Week 8 - Monday, December 16
No significant changes as work was focused in other areas.
Week 7 - Monday, December 9
Removed siding and window/door mouldings from walls. Siding removal was a slow process since I wanted to save as much as possible for outside use in the areas where windows would replace doors. It was very brittle and I managed to save about 1/3. Nailed subfloor to joists.
Floors were stained and polyurethane applied. Started to cut moulding. Walls were primed.
Week 13 - Monday, January 20
Wood floor installed. Drywall installation completed.
Week 12 - Monday, January 13
Painted ceiling. Drywall installation started. Electrical boxes moved and switches, receptacles replaced with white units.
Week 11 - Monday, January 6
Windows and insulation were installed. Plywood subfloor was installed.
Christmas - no work.
Week 9 - Friday, December 20
No significant changes as work was focused in other areas.
Week 8 - Monday, December 16
No significant changes as work was focused in other areas.
Removed siding and window/door mouldings from walls. Siding removal was a slow process since I wanted to save as much as possible for outside use in the areas where windows would replace doors. It was very brittle and I managed to save about 1/3. Nailed subfloor to joists.
Week 6 - Monday, December 2
Due to Thanksgiving travel, no significant changes as work was focused on vendor contacts.
Due to Thanksgiving travel, no significant changes as work was focused on vendor contacts.
Week 5 - Monday, November 26
Removed subfloor. Cleaned up nails in floor.
Removed carpet. Started removal of siding on front wall.
Week 3 - Monday, November 12
No significant changes as work was focused in other areas.
Week 2 - Monday, November 5
No significant changes as work was focused in other areas.
No significant changes as work was focused in other areas.
