Kitchen

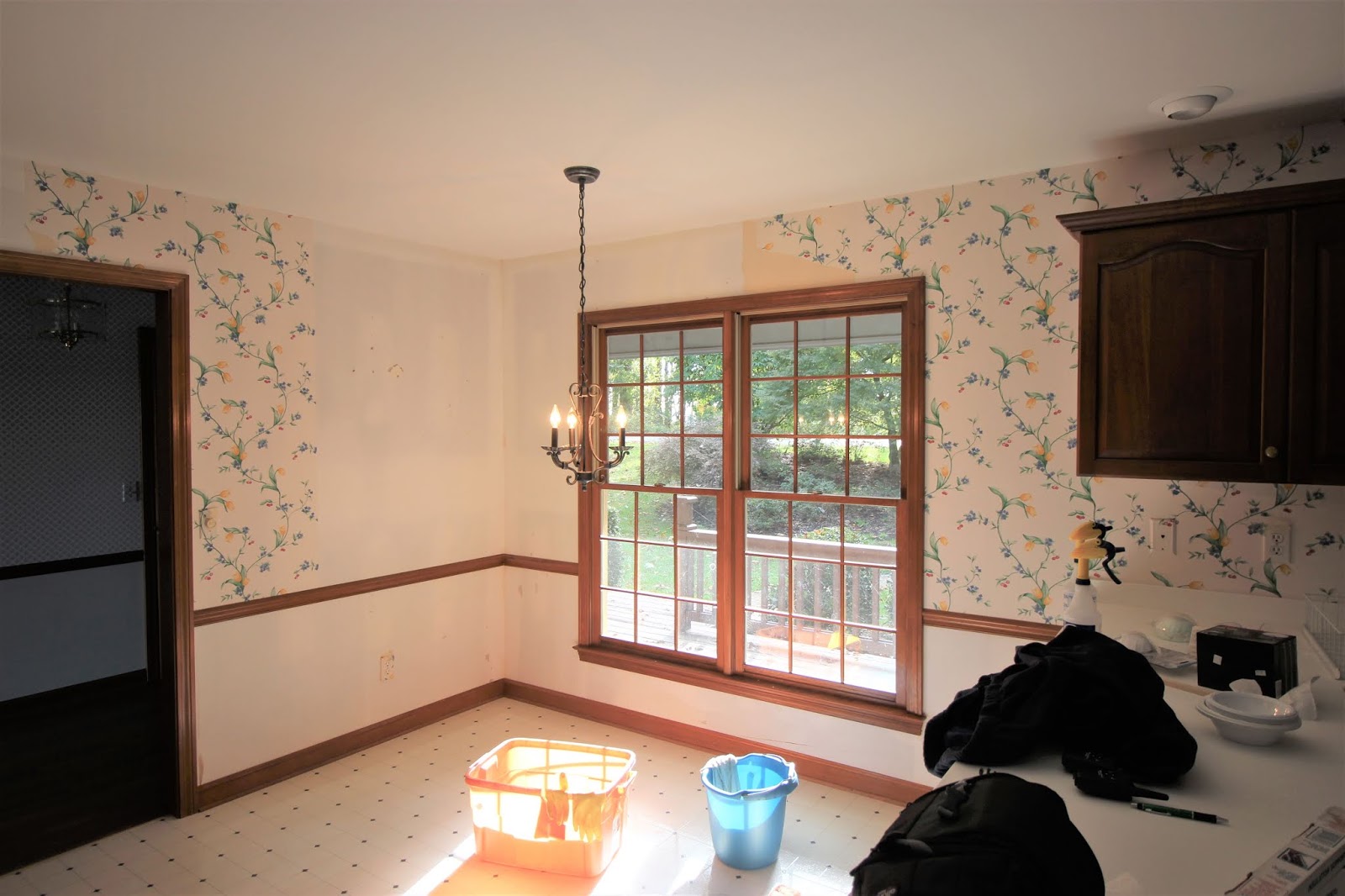

Original Condition on Closing Day
Plans - Everything will be replaced - cabinets, floor, windows, lights, and appliances. The wallpaper will be stripped and the molding will be painted white while leaving the doors as natural wood.
Week 26 - Monday, April 20
Installed range.
Week 25 - Monday, April 13
Contractor installed counter tops. Installed door and new hardware on large pantry.
Week 24 - Monday, April 6
No significant changes as work was focused in other areas.
Week 23 - Monday, March 30
Installed door and new hardware on small pantry.
Week 22 - Monday, March 23
Installed moulding and closet shelves. Caulked and painted mouldings.
Week 21 - Monday, March 16
Appliances put in place. Cut and painted moulding for pantries.
Week 20 - Monday, March 9
Cut and installed moulding.
Week 19 - Monday, March 2
No significant changes as work was focused in other areas.
Week 18 - Monday, February 24
Floor installation was completed.
Week 17 - Monday, February 17
Installed moulding and painted pantries.
Week 16 - Monday, February 10
Finished cabinet installation. Cut moulding.
Week 15 - Monday, February 3
Painted walls. Cabinet installation started. Started moulding installation.
Week 14 - Monday, January 27
Floors were stained and polyurethane applied. Started to cut moulding.
Week 13 - Monday, January 20
Wood floor installed.
Plumber cleaned up sink connections in preparation for cabinet installation. Painted ceiling. Walls repaired and primed.
Week 11 - Monday, January 6
Installed plywood subfloor. Windows were installed. Removed last cabinet from wall.
Week 10 - Monday, December 30
Christmas - no work.
Week 9 - Friday, December 20

Installed plywood subfloor in pantries.
Week 8 - Monday, December 16
Electrician rewired range to future microwave, rewired switch for dishwasher to future island lights, moved or removed recessed lights, and wired basement for future island receptacle. Removed range. Removed window mouldings.
Week 7 - Monday, December 9
Removed upper cabinets. Nailed subfloor to joists.
Week 6 - Monday, December 2
Due to Thanksgiving travel, no significant changes as work was focused on vendor contacts.
Week 5 - Monday, November 26
Removed more base cabinets. Range remains until electrician disables. Removed vinyl floor and
subfloor. Removed mouldings.
Large Pantry. Removed vinyl floor and subfloor. Removed mouldings.
Small Pantry. Removed vinyl floor and subfloor. Removed mouldings.
Removed base cabinets.
Completed chair rail removal. Primed and caulked some mouldings.
Completed wallpaper removal. Began removal of chair rail and started wall repair. Removed window mullions.
Week 1 - Monday, October 28
Removed curtains, blinds, and hardware. Began wallpaper removal.
Plans - Everything will be replaced - cabinets, floor, windows, lights, and appliances. The wallpaper will be stripped and the molding will be painted white while leaving the doors as natural wood.
Week 26 - Monday, April 20
Installed range.
Week 25 - Monday, April 13
Contractor installed counter tops. Installed door and new hardware on large pantry.
Week 24 - Monday, April 6
No significant changes as work was focused in other areas.
Week 23 - Monday, March 30
Installed door and new hardware on small pantry.
Week 22 - Monday, March 23
Installed moulding and closet shelves. Caulked and painted mouldings.
Week 21 - Monday, March 16
Appliances put in place. Cut and painted moulding for pantries.
Week 20 - Monday, March 9
Cut and installed moulding.
Week 19 - Monday, March 2
No significant changes as work was focused in other areas.
Week 18 - Monday, February 24
Floor installation was completed.
Week 17 - Monday, February 17
Installed moulding and painted pantries.
Week 16 - Monday, February 10
Finished cabinet installation. Cut moulding.
Week 15 - Monday, February 3
Painted walls. Cabinet installation started. Started moulding installation.
Week 14 - Monday, January 27
Floors were stained and polyurethane applied. Started to cut moulding.
Week 13 - Monday, January 20
Wood floor installed.
Week 12 - Monday, January 13
Plumber cleaned up sink connections in preparation for cabinet installation. Painted ceiling. Walls repaired and primed.
Week 11 - Monday, January 6
Installed plywood subfloor. Windows were installed. Removed last cabinet from wall.
Christmas - no work.
Installed plywood subfloor in pantries.
Electrician rewired range to future microwave, rewired switch for dishwasher to future island lights, moved or removed recessed lights, and wired basement for future island receptacle. Removed range. Removed window mouldings.
Week 7 - Monday, December 9
Removed upper cabinets. Nailed subfloor to joists.
Week 6 - Monday, December 2
Due to Thanksgiving travel, no significant changes as work was focused on vendor contacts.
Week 5 - Monday, November 26
Removed more base cabinets. Range remains until electrician disables. Removed vinyl floor and
subfloor. Removed mouldings.
Large Pantry. Removed vinyl floor and subfloor. Removed mouldings.
Small Pantry. Removed vinyl floor and subfloor. Removed mouldings.
Week 4 - Monday, November 19
Removed base cabinets.
Week 3 - Monday, November 12
Completed chair rail removal. Primed and caulked some mouldings.
Week 2 - Monday, November 5
Completed wallpaper removal. Began removal of chair rail and started wall repair. Removed window mullions.
Removed curtains, blinds, and hardware. Began wallpaper removal.
